Thursday, July 28, 2016

Project Management Examples

PERT/CPM Example

Figure 3-25 shows a list of 11 tasks. The example is more complex, but the same guidelines apply. Notice that each task has an ID, a description, a duration, and a reference to predecessor tasks, if any, which must be completed before the task can begin. Also notice that dependent tasks can have one predecessor task, or several. You construct a PERT/CPM chart from this task list in a two-step process:





STEP 1: CREATE THE WORK BREAKDOWN STRUCTURE
In the first step, as shown in Figure 3-26 , you identify the tasks, determine task
dependencies, and enter the task name, ID, and duration. Notice that this example includes dependent tasks, multiple successor tasks, and multiple predecessor tasks.


STEP 2: ENTER START AND FINISH TIMES
In the second step, as shown in Figure 3-27, you enter the start and finish times by applying the guidelines in this section. For example, Task 1 has a one-day duration, so you enter the start and finish times for Task 1 as Day 1. Then you enter Day 2 as the start time for successor Tasks 2 and 3. Continuing from left to right, you add the task duration for each task to its start time to determine its finish time. As you proceed, there are three important rules you must keep in mind:
• If a successor task has more than one predecessor task, use the latest finish time of the predecessor tasks to determine the start time for the successor task.
• If a predecessor task has more than one successor task, use the predecessor task’s finish time to determine the start time for all successor tasks.
• Continuing from left to right, add the task duration for each task to its start time to determine and enter its finish time. Again, be very careful not to add too many days. For example, if a task starts on Day 10 and has a duration of 5 days, then the finish would be Day 14 — not Day 15. When you enter all the start and finish times, you determine that the project will be completed on Day 155. Also, you note that Tasks 1, 2, 4, 6, 9, and 11 represent the critical path shown by the red arrows.


Software-Driven Example

Project managers use powerful software to help plan, schedule, monitor, and report on a project. Most project management programs offer features such as PERT/CPM, Gantt charts, resource scheduling, project calendars, and cost tracking. Microsoft Project is a full-featured project management program that holds the dominant share of the market. On the Web, Microsoft offers demo versions, training, and tips. Although Microsoft is the industry leader, many other vendors offer project management software, and you can explore these options by searching on the Web. One product, Open Workbench, is available as free software, complete with manuals and sample projects, as shown in Figure 3-28.
Altenatively, you can use ProjectLibre for the same purpose. For many small to medium-sized projects, Open Workbench/ProjectLibre would be a cost-effective alternative that would compare favorably to Microsoft Project. Open Workbench also can exchange files with Microsoft Project by importing and exporting the data in XML file format. When you use project management software, you follow the same step-by-step process to develop a WBS and create various types of charts. The following sections focus on some basic concepts, but most programs include many powerful features, such as automated reporting tools, and convenient data import-export tools.

WORK BREAKDOWN STRUCTURE

You already know how to create a work breakdown structure. If you are using Microsoft Project or Open Workbench, the process is exactly the same. You must identify the tasks, durations, and task patterns. You might have to develop this information on your own, or you might work with a task summary like the one in Figure 3-29. Your manager would like you to create a Gantt chart and a PERT chart that show all tasks, dependencies, dates, and total project duration. Your first step is to create a Gantt chart showing the necessary information. You decide to use Microsoft Project to construct the chart. As you enter each task, you also enter the duration and the predecessor tasks, if any.

GANTT CHART

As you enter the tasks, durations, and predecessor tasks, the program automatically performs the calculations, detects the task patterns, and creates a Gantt chart similar to the one shown in Figure 3-30. The chart consists of 12 horizontal bars, connected with arrows that indicate the task dependencies. Notice that Saturdays and Sundays are shown as shaded columns, because no work will be performed on those days. The program makes these adjustments automatically. For example, Task 2, which has a duration of three days, starts on Thursday and ends on Monday.


NETWORK DIAGRAM

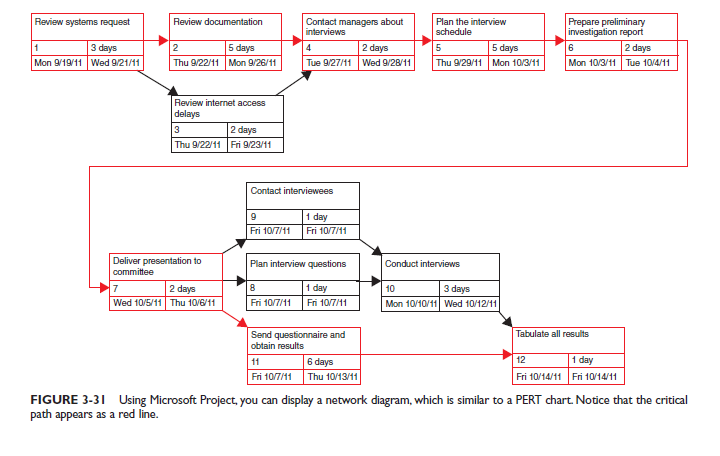

After you complete the Gantt chart, you decide to view the data in the form of a Microsoft Project network diagram, which is similar to a PERT chart. When you select the Network Diagram option on the View menu, you can see the project tasks and dependencies, as shown in Figure 3-31.
You study the diagram and see that the program has calculated a start and finish date for each task. Notice that the diagram displays the same information as the Gantt chart, including task dependencies, and also includes a red line that indicates the project’s critical path. According to the diagram, if the project remains on schedule, the last task will be completed on Friday, October 14, 2011. Notice that the task boxes in Microsoft Project are similar to PERT/CPM task boxes. Using Microsoft Project, you can assign each task to one or more people, assign budget targets, produce progress reports, and readjust schedules and deadlines as necessary. The latest version of Project is Microsoft Project 2010. This release is offered in a Standard version, a Professional version, and a Server version that includes support for large, enterprise-wide projects. In addition to providing a full description, demos, and training on its Web site, Microsoft also offers a free 60-day trial version that allows you to install, use, and evaluate the program.An alternative to Microsoft Project is the Open Workbench program, which is free.
Figure 3-32 shows the Open Workbench
version of the same project shown in Figure 3-30 on the previous page. Using Open Workbench, you create tasks and durations, indicate dependencies, and assign resources, just as you would in Microsoft Project. Notice that the critical path is highlighted, both in the Gantt chart and the network diagram. Regardless of which software you use, you can see from these examples that project schedules, task estimates, and personnel assignments all are interrelated. Therefore, project planning is a dynamic task and involves constant change. One significant advantage of integrated interactive project management software is that it allows the project manager to adjust schedules, estimates, and resource assignments rapidly to develop a workable plan.
